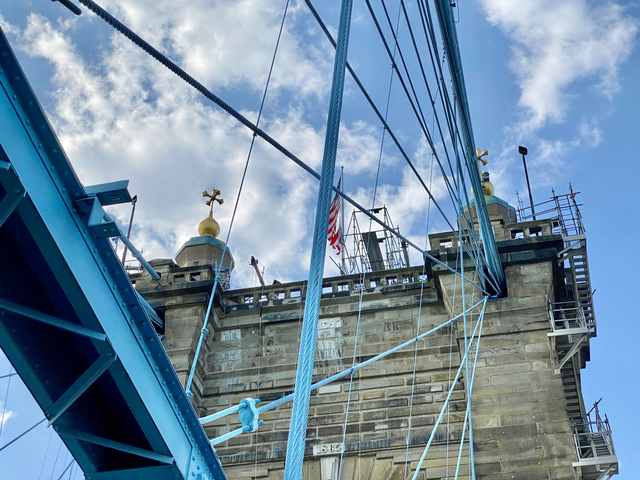

Four inspectors rappelled down the Roebling Suspension Bridge during an in-depth inspection in 2018. Their findings became locations on repair drawings: AECOM used written field notes, photographs and engineering judgement to mark where work was needed. The process was laid out for prospective contractors at a September 2020 meeting. [1]

Those drawings did not settle every repair. The presentation said final repair types would be determined in the field, with additional quantities allowed for unknowns—including the depth of sound concrete and deterioration since the 2018 inspection. The contractor was to record the final locations and quantities on plan sheets. [1]

Where is this place?

John A. Roebling Suspension Bridge, Covington–Cincinnati. This map locates the town or region, not a verified exact historic event site.

Open this location in Google Maps ↗

The stone towers stand over a working route between Covington, Kentucky, and Cincinnati, Ohio. A January 2021 City of Covington announcement described the coming $4.7 million restoration: sections of sandstone on towers and anchorages would be repaired or replaced, alongside smaller deck and sidewalk jobs. Safety netting had already been installed during a 2019 closure to catch fragments from the north tower. [2]

There was another kind of detail to get right at street level. Kristin Steuber, then identified by the city as owner of The Gruff restaurant near the bridge approach, wanted access to her business kept clear. She asked that detour or closure signs should not mistakenly tell customers that nearby streets and businesses were closed too. Her concern appeared in the same city announcement as the masonry work. [2]

The suspension bridge crosses the river toward a city skyline, with parked cars in the foreground.
“Roebling Bridge from Riverfront Commons, Covington, KY” — Warren LeMay (w_lemay), 18 July 2021. The crossing and Cincinnati riverfront. CC BY-SA 2.0, via Wikimedia Commons.Photo: Warren LeMay (w_lemay) · Source · CC BY-SA 2.0 · Colour-managed from embedded Display P3 to sRGB; resized and JPEG-recompressed.

The 2020 presentation had anticipated a full vehicle closure from February to November 2021. In its March–April 2022 newsletter, the Kentucky Transportation Cabinet reported that the bridge had reopened to vehicles after fourteen months. Its account described the restoration as sufficiently complete for that reopening. [1][3]
